Insight, Governance & Minerals

The Permit Is Not the Project

Five organisations have accused the Commission of deciding to reopen Europe's water law before gathering the evidence for it. The dispute looks like water against mining. It is really about which statistic a permitting reform is optimising, and the one being measured is not the one that matters.

Line-art scene: a stopwatch in the foreground stopped at a short reading, sitting on a stamped permit document; behind it and much larger, an unbuilt processing plant drawn in outline with scaffolding, a group of small figures holding placards at its gate, and a courthouse in the far distance, all connected by a long dotted line running past the stopwatch.
The stopwatch measures the first part of this picture. The project is the whole of it.

Europe is optimising the wrong clock

Five environmental organisations lodged a formal complaint with the European Ombudswoman on 8 September, alleging maladministration by the European Commission over its decision to revise the Water Framework Directive. The complainants are the European Anglers' Alliance, the European Environmental Bureau, Surfrider Foundation Europe, Wetlands International Europe and the WWF European Policy Office.

The substance of the complaint is a sequence rather than a position.

In December 2025 the Commission announced it would review and revise the Directive as part of its RESourceEU Action Plan, citing the need to facilitate access to critical raw materials. The Call for Evidence followed on 17 March 2026, three months after the political decision had already been taken. And the consultation invited stakeholders to provide evidence of the bottlenecks facing the raw materials sector, despite those same bottlenecks having already been used to justify the announced revision.

Reuters places this within a broader pattern, the EU omnibus strategy of simplifying and scaling back rules in response to industry arguments about competitiveness, with mining and metals companies arguing that environmental safeguards are delaying permits for critical raw materials projects.

The obvious framing is water protection against mineral access. That framing is available, it is the one both sides are using, and it is not the most useful one.

Two diagnoses, and only one is being acted on

Set this beside something that happened in the same week.

Twenty-three of the European Union's sixty designated strategic critical mineral projects have told the Commission they may not reach a final investment decision, citing liquidity and financing constraints. Not permitting. Financing.

So Europe has two accounts of why its mineral projects are not being built, arriving simultaneously from different parties. The industry associations say the constraint is environmental permitting. A large minority of the actual projects say the constraint is capital.

Both can be true for different projects, and it is entirely possible that permitting delay and financing difficulty compound each other, since a project with an uncertain permitting timeline is harder to finance. But they are different diagnoses implying different remedies, and only one of them is currently generating legislative action.

That is worth noticing before anybody reopens a twenty-five-year-old directive, because if the binding constraint is the cost of capital under commodity price volatility, then amending water law will not build a single plant.

Input, output and the part in between

Fritz Scharpf's Governing in Europe gave European governance its most durable analytical distinction. Input legitimacy is government by the people, resting on participation and responsiveness. Output legitimacy is government for the people, resting on effective problem-solving.

The European Union has always leaned heavily on the second. It is not directly elected in the way a national government is, its democratic connection is indirect, and its claim to authority has rested substantially on being effective at things member states cannot do alone.

Vivien Schmidt later added a third term, and it is the one this dispute turns on. Throughput legitimacy concerns the quality of the process between input and output: its efficacy, accountability, transparency, inclusiveness and openness.

Read the complaint through that lens and it is not really about water. It alleges that the decision was taken first and the evidence gathered afterwards, and that the consultation asked for support rather than for findings. Whether or not the Ombudswoman upholds it, that is a throughput claim, and throughput is the dimension on which European institutions are most often challenged and least able to defend themselves by pointing at results.

Simplification is an output legitimacy move. It is being paid for in throughput legitimacy, and nobody has costed that.

The clock that is being optimised, and the one that matters

Here is the practical version of the same point, and it is measurable.

Permitting reform is assessed against a specific statistic: the elapsed time from application to decision. That number is published, it is comparable across jurisdictions, it is what industry associations cite, and it is what a reform is designed to reduce.

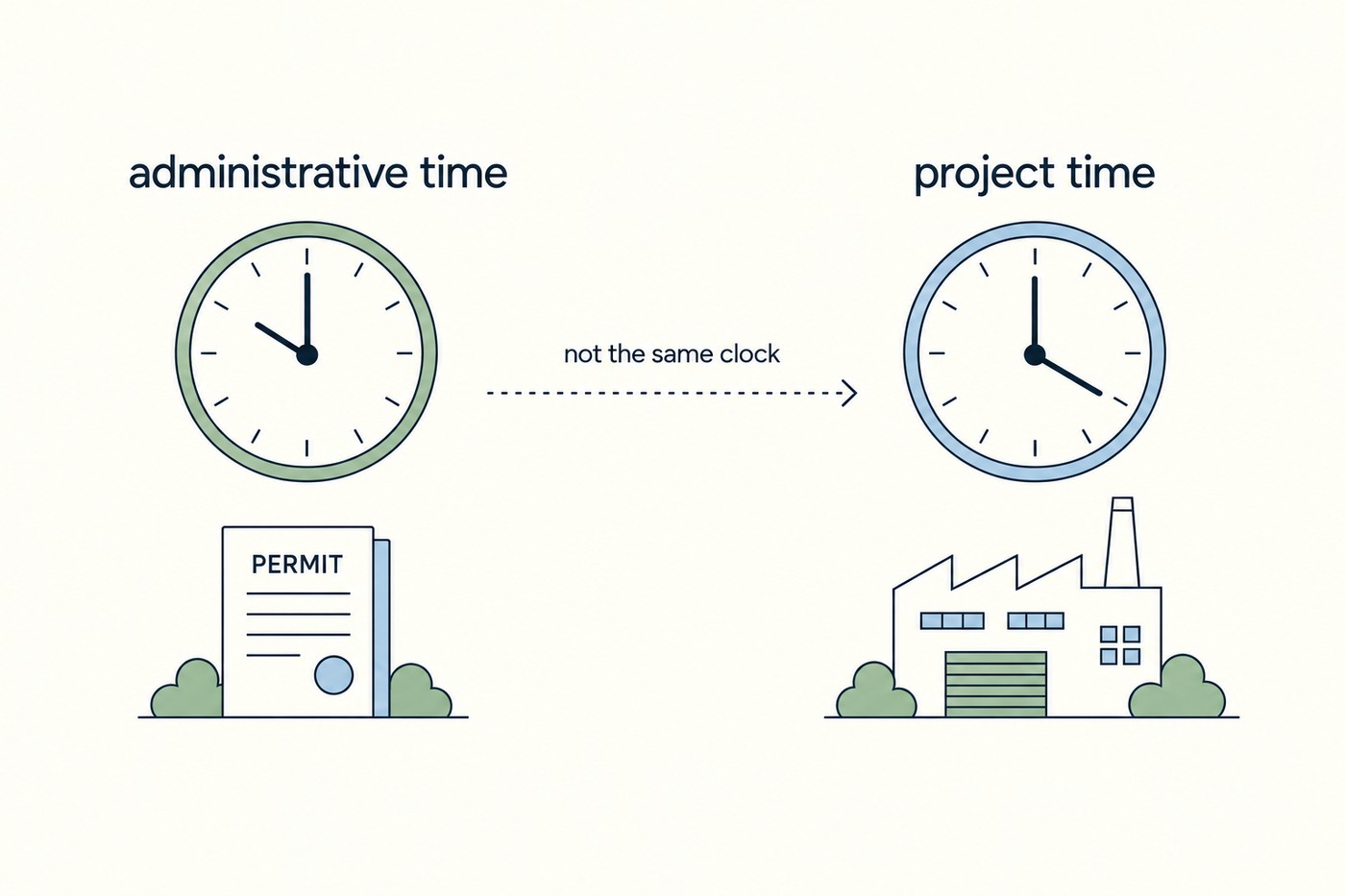

Diagram: two clocks side by side. On the left, a sage-green clock labelled 'administrative time' with a permit document beneath it. On the right, a sky-blue clock labelled 'project time' with a factory beneath it. A dashed arrow runs between them annotated 'not the same clock'.
Two clocks, one file. Reform is optimising the left one.

The number that determines whether a country gets a mine is different. It is the time from decision to operation, and it contains things the first number excludes: judicial review, appeal, injunction, protest, renegotiation with a municipality, a condition imposed late because it was not imposed early, and the construction delay that follows from any of them.

A permitting process that is fast and contested can produce a slower project than one that is slow and accepted.

Chart, 'Delay accumulates after approval'. A horizontal stacked bar starts at a 'permit granted' marker and runs to the right, divided into five segments each labelled with a small scene above: finance (coin stack), land (field), procurement (warehouse), grid connection (pylon), construction (crane and building). A bracket beneath the whole bar reads 'time before the project exists'. Footnote: Stage lengths are schematic. Transitions Lab, 2026.
The permit clock stops here. The project clock has not yet begun.

That is not a hypothesis about the future. It is the ordinary history of contested infrastructure, and the mechanism is simple. Objections that cannot be raised during a process are raised after it, in a forum with less flexibility and more delay. A consultation is cheap. A judicial review is not.

The evidence is already in this file. A deregulatory measure announced in December 2025 to accelerate access to raw materials has, within nine months, produced a formal complaint to the Ombudswoman. That proceeding is itself time, and it arrived before a single permit was granted under the revised rules, which do not yet exist.

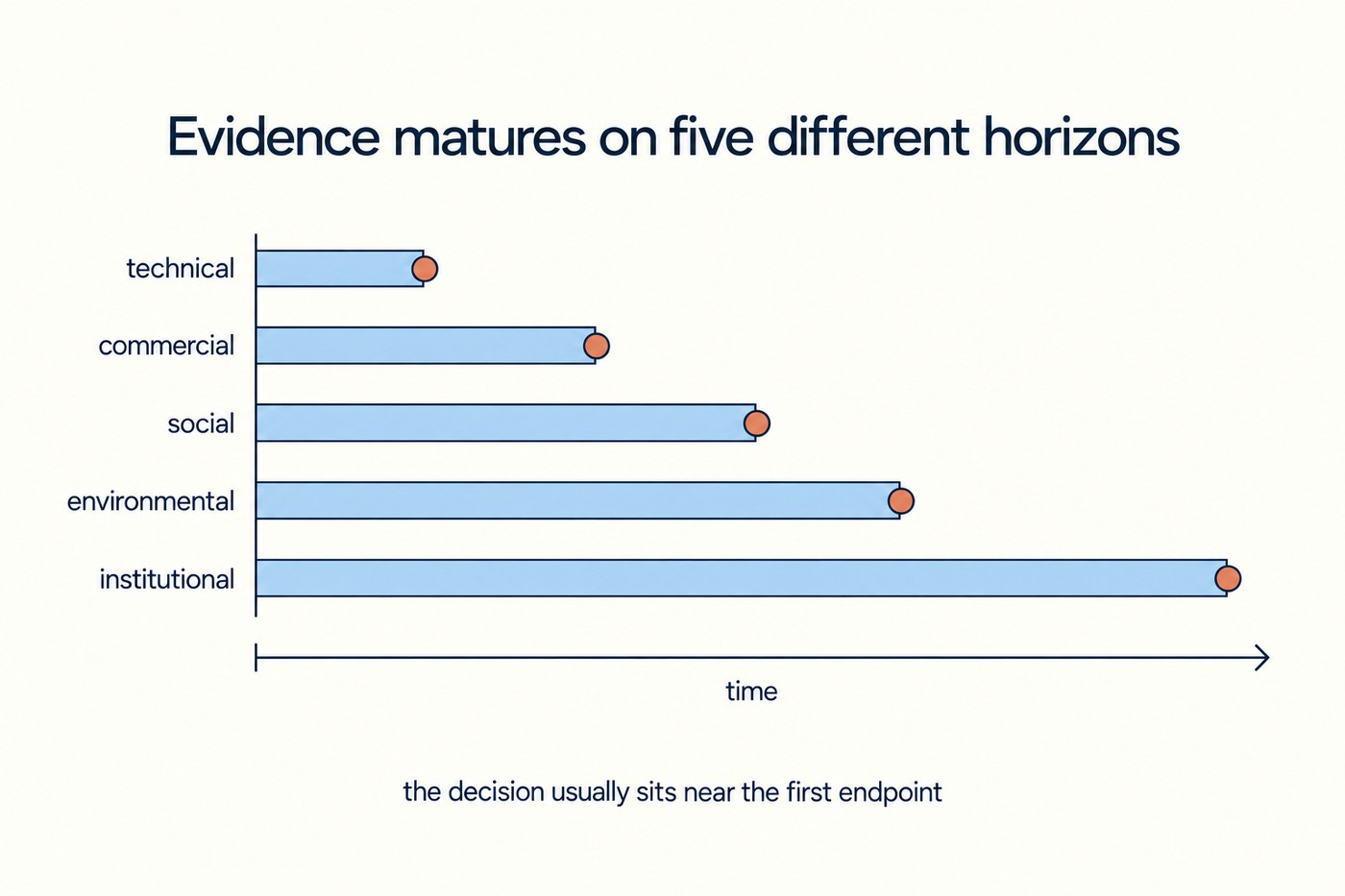

Chart, 'Evidence matures on five different horizons'. Five horizontal sky-blue bars of increasing length labelled from top: technical (shortest), commercial, social, environmental, institutional (longest). Each bar terminates in a coral dot marking when that kind of evidence has matured. Time axis runs left to right beneath. A note reads 'the decision usually sits near the first endpoint'.
The decision is taken at the shortest horizon. The evidence for the others arrives later and, when it disagrees, arrives in a courtroom.

Nobody publishes the second number. That is the research question, and it is answerable: take the European mining and processing projects permitted over the last fifteen years, measure decision-to-operation alongside application-to-decision, and see whether the jurisdictions with the fastest permits have the fastest projects.

Why water specifically is the hard case

There is a reason this fight is about water rather than, say, noise or landscape.

Mining and mineral processing are water-intensive and water-risky. Tailings management, acid drainage and the long-term integrity of storage facilities are the failure modes that produce the incidents people remember, and they are failures that travel downstream into catchments used by everybody else. Water is also the resource with the widest and most attentive constituency, because every settlement, farm and fishery in a basin has a stake in it.

And the timing is unhelpful. Europe has just come through a summer of drought and wildfire, and we have argued that the fire problem is substantially a rural land management problem rather than only a climate one. A proposal to relax water rules in that context will be read against that backdrop whether or not the two are technically connected.

None of which makes the industry's complaint illegitimate. If permitting genuinely is slower in Europe than in comparable jurisdictions for reasons unrelated to environmental outcomes, that is a real problem and worth fixing. The argument here is narrower: that it should be established before it is acted on, and that acting first makes the fix more expensive even when the fix is correct.

What would be worth measuring

Decision-to-operation time, alongside application-to-decision. The single missing statistic, obtainable from existing records, and the one that would settle whether faster permitting produces faster projects.

The decomposition in the box. Where the time in a permit actually goes, by component, across a sample of European projects.

Litigation rates by process type. Whether projects permitted under accelerated procedures are challenged more often than those permitted conventionally. If they are, the acceleration is shifting time rather than saving it.

What the affected municipality says at year three. Not whether consultation occurred, but whether the people living alongside the project consider the process to have been fair, and whether they would accept another one. That is the asset a country spends when it accelerates a permit, and it is the only one that is not replenished by the next funding round. It is the same implementation capacity question that determines what any European plan actually delivers.

Europe wants faster mineral development, water protection, public legitimacy and strategic autonomy at the same time. That is not an impossible combination, and it is not a matter of picking one. It is a design problem about holding several objectives under conflict, and the design question has an unglamorous answer: build the evidence first, because the process you skip is the delay you get later.

The Lab works on this in climate and ecosystems and water and sanitation, and on what a project means to the place it lands in through entering a new context.

If you are assessing a permitting reform and want to know which clock it actually changes, tell us what you need to know.
